Migrating to an AI CRM means moving accounts, contacts, deals, activities, custom fields, and integrations to a new platform without losing the history that drives every AI feature. IDC research on CRM modernization shows poor data hygiene as the single largest failure point, so the migration plan that survives is one that treats data preparation as the project, not the prelude.

Why CRM Migrations Fail the First Time

Every revenue leader who has lived through a CRM migration has the same story. The new platform was demoed beautifully, the project plan was signed, the cutover weekend arrived, and the team discovered Monday morning that the deal history was missing, the account hierarchies were flattened, three custom fields the team relied on did not come across, and the email sync was firing duplicate threads at every contact. The migration was technically successful and operationally a disaster, and the team spent the next two quarters rebuilding what should have moved cleanly the first time.

IDC's research on CRM modernization is consistent on the cause. The single largest failure point in any data migration is not the destination platform's capability, the integration partner's skill, or the cutover weekend's tooling. It is data hygiene in the source system before migration begins. Garbage in, garbage out, except that the new AI CRM is now running predictive scoring and natural-language explanation on top of the garbage, so the consequences compound rather than fade.

This article walks through the migration sequence that survives: the three phases of data preparation, build, and cutover, what each phase actually requires, the integration cutovers that hurt the most, and the Authority Solutions® AI Services path for migrating mid-market revenue organizations from Salesforce Classic, legacy HubSpot, Microsoft Dynamics on-prem, or any small-business CRM to a modern AI-enabled platform without losing the history that makes the AI useful.

Phase One: Data Preparation Is the Project

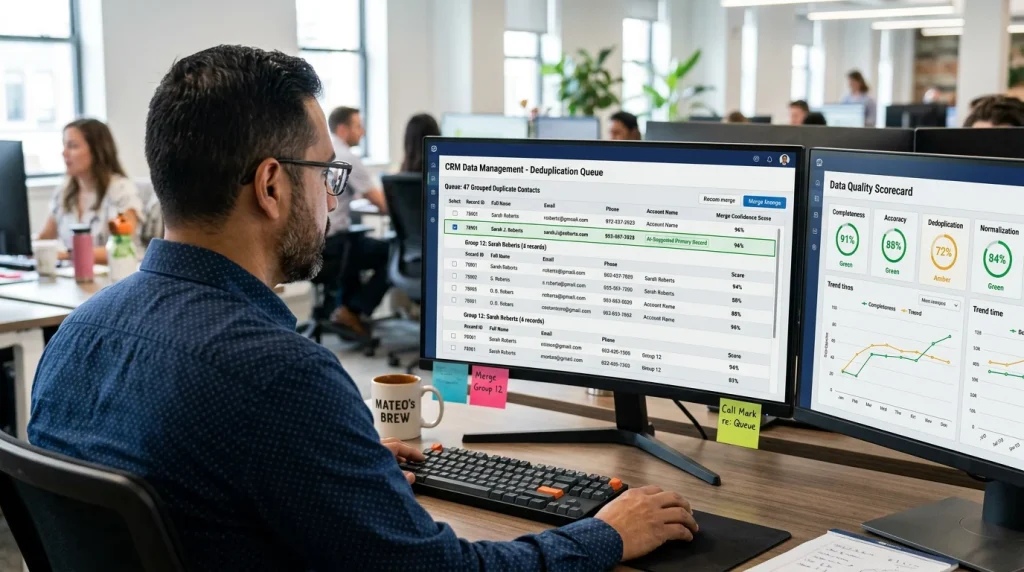

Sales operations analyst reviewing AI-suggested deduplication merges during CRM migration data preparation

The single most important reframe in a CRM migration plan is that data preparation is the project, not the prelude. The cutover weekend gets the attention because it is dramatic; the four to six weeks of data work before it determine whether the cutover succeeds.

The data preparation work covers:

  • Object inventory. A complete map of every object in the source CRM that will move: standard objects, custom objects, custom fields, picklists, validation rules, automations. Sometimes the inventory surfaces objects nobody knew existed; those decisions get made before mapping starts.
  • Deduplication. Most legacy CRMs accumulate duplicate accounts and contacts over years. The dedupe pass uses AI matching to surface candidate groups, the operations team reviews and merges, and the source CRM is clean before any export runs.
  • Normalization. Inconsistent values in country fields ("US," "USA," "United States," "U.S.A."), in industry classifications, in titles and seniority. The normalization layer is built before migration so the destination receives consistent values.
  • Enrichment. Missing firmographic data on accounts, missing contact roles, missing deal source attribution. AI-driven enrichment fills the gaps before they become the destination platform's responsibility.
  • Decay clearance. Inactive accounts, bounced contacts, abandoned deals. The team decides what to migrate fresh and what to archive separately, and the migration carries only the live data.
  • Custom field rationalization. Most source CRMs have dozens of custom fields that no one uses anymore. The migration is the moment to retire them; the destination platform starts clean.

A team that does the data work properly during phase one buys itself a successful phase three. A team that skips the data work pays for it on cutover Monday and every Monday after, which is why Authority Solutions® CRM Implementation treats data preparation as the project rather than the prelude.

Phase Two: Build the Destination With the Future in Mind

The destination CRM is not a copy of the source CRM. The team that tries to recreate the source one-for-one in the destination misses the upgrade reason and saddles itself with the same legacy decisions in a new wrapper.

Phase two covers:

  • Object model design. The destination's account, contact, deal, and activity model gets designed for how the team will operate, not how the legacy system forced them to operate. The AI features in the destination expect specific structures; the build matches those.
  • Lifecycle stage definition. Pipeline stages get cleaned up. The "Discovery / Qualification / Discovery 2 / Pre-Proposal / Proposal" mess from the legacy system becomes a sharp four-stage funnel that the AI can score against.
  • Custom field rebuild. The fields that survived rationalization get rebuilt with consistent naming and clear purpose. Field documentation lives in the platform, not in someone's head.
  • Permission and role design. Who sees what, who edits what, who reports on what. Permission design before data import is much easier than after.
  • Integration scoping. Email sync, calendar sync, marketing automation, support system, billing, product analytics. Each integration's scope, refresh cadence, and field mapping is documented.
  • AI feature configuration. Predictive scoring, lead routing, conversation intelligence, natural-language reporting. Each AI feature is configured against the cleaned data structure, ready to run from day one.

The destination platform is what the team will live in for the next five years. The thirty days of build effort in phase two compound for the entire ownership period, and Authority Solutions® Salesforce Implementation brings the design discipline that pays back across the ownership horizon.

Phase Three: The Cutover Weekend

CRO reviewing a completed cutover-weekend migration dashboard with reconciled record counts in a Houston conference room

The cutover is the visible moment that gets the attention. With phases one and two done well, the cutover is mechanical; with them done poorly, the cutover is a crisis.

The cutover sequence:

  • Friday afternoon: freeze. The legacy CRM goes read-only. Users are notified the system is frozen for the weekend; the team is given access to a holding workspace for any urgent updates that come up.
  • Friday evening: final export. Full export of every object with timestamp and record count. This is the canonical source for everything that follows.
  • Saturday: load and reconcile. The destination loads from the export. Record counts reconcile per object. Any reconciliation gap pauses the load until it is explained.
  • Sunday: integration cutover. Email sync repoints, calendar sync repoints, marketing automation refreshes, support system links to new IDs, billing system links to new IDs. Each integration's first refresh is monitored.
  • Sunday evening: smoke tests. A defined script walks the destination through the team's most common workflows. Any failure pauses go-live until resolved.
  • Monday morning: managed go-live. The team enters the new system. Office hours run all day. Issues are triaged in real time; nothing is dismissed.

By Monday afternoon the team is operating in the new CRM, the data history is intact, the integrations are firing, and the AI features have started producing the insights the upgrade was for.

The Integrations That Cause the Most Pain

Three integration categories cause more migration pain than all the others combined. Each deserves explicit design attention:

  • Email and calendar sync. Threads get duplicated, calendar invites get re-sent, contact owners get re-assigned. The fix is to migrate the contact and account IDs with a stable cross-reference, repoint the sync to the new IDs, and disable historical re-sync for any thread before the cutover date.
  • Marketing automation. Marketing programs reference contact IDs; if the IDs change, the running campaigns break. The fix is to maintain ID stability through the migration, or to pause campaigns through the cutover weekend and reactivate against the new IDs.
  • Billing and payment systems. Customer records in billing must continue to reference the right CRM account. The fix is a billing-side audit before the migration, an ID reconciliation during the cutover, and a finance walkthrough on the Monday after.

The migration plan should treat each of these as a sub-project with its own owner and its own checklist. The general "we will handle integrations" line in a project plan is where most migrations break, and Authority Solutions® Workflow Automation runs each integration cutover as a named sub-project.

What "Successful" Looks Like 30 Days Out

The metrics that prove the migration succeeded:

  • Data completeness. Source-to-destination record counts reconcile to 100 percent per object. Custom field population matches expected coverage.
  • Adoption rate. Daily and weekly active users at 95 percent or higher of pre-migration baseline within 30 days.
  • Pipeline integrity. Forecast accuracy and pipeline coverage are unchanged or improved 30 days post-cutover.
  • Integration stability. Email sync, calendar sync, and marketing automation operating without manual reconciliation.
  • AI feature usage. Predictive scoring, conversation intelligence, and natural-language reporting being used by the teams they were configured for.

The migration that hits all five within 30 days is a clean success. The migration that misses one is a tuning problem, addressable. The migration that misses three is a project that should not have launched without phase one being done properly.

Where Migration Plans Underestimate Cost

Three cost lines get underestimated in almost every CRM migration RFP:

  • Data preparation labor. Operations teams underestimate the dedupe, normalization, and enrichment hours by half. The fix is to build the destination team or partner before mapping starts and to staff phase one realistically.
  • Integration rework. Every integration assumes the field mapping is simple until the team starts mapping. The fix is to walk every integration's actual flow before quoting the project.
  • Adoption and training. Users are expected to figure out the new platform from documentation, then need three weeks of side-by-side help they were not budgeted for. The fix is to plan office hours, role-specific training, and manager coaching support from the cutover Monday.

A migration RFP that does not account for these three is going to overrun. The honest plan staffs and budgets for each.

The Authority Solutions® Migration Path

Our CRM migration engagement for mid-market revenue organizations runs roughly twelve weeks:

  • Weeks 1 to 4. Data preparation. Object inventory, dedupe, normalization, enrichment, decay clearance, custom field rationalization. The legacy CRM is clean before any export runs.
  • Weeks 5 to 8. Build. Destination object model, lifecycle stages, custom fields, permissions, integration scoping, AI feature configuration. The destination is ready to receive clean data.
  • Weeks 9 to 11. Test cutover and rehearsal. A dry-run cutover into a sandbox of the destination, with full reconciliation and integration test. Any gap surfaces here, not on the live weekend.
  • Week 12. Live cutover weekend and managed go-live. Friday freeze, Saturday load, Sunday integrations, Monday office hours. By Friday of the go-live week the team is operating in the new system with the data history intact.

By week twelve the team has the platform the upgrade was for, the data history that makes the AI features useful, and the integrations that connect the daily work. The migration becomes a non-event in the team's memory because the project planned for it to be one, and Authority Solutions® AI Training Programs closes the engagement by training the team on the AI features the new CRM now exposes.

Key Takeaways

  • CRM migrations fail in phase one, not phase three. IDC's research consistently identifies poor source-system data hygiene as the largest failure factor; the team that treats data preparation as the project, not the prelude, ships a clean migration.
  • Phase two is the destination build. The destination CRM is not a copy of the source CRM; it is the platform the team will live in for five years, designed for how the team should operate, not how the legacy system forced them to operate.
  • Phase three is mechanical when phases one and two are done well. Friday freeze, Saturday load and reconcile, Sunday integration cutover, Monday managed go-live with office hours. The visible moment becomes a non-event.
  • Email sync, marketing automation, and billing integration cause the most pain. Each deserves a sub-project, its own owner, and its own checklist. The general "we will handle integrations" approach is where migrations break.
  • Three cost lines get underestimated in every migration RFP: data preparation labor, integration rework, and adoption and training. The honest plan staffs and budgets for each before the project signs.
  • Success at 30 days out means 100 percent record reconciliation, 95 percent or higher user adoption, unchanged or improved pipeline integrity, stable integrations, and AI feature usage by the teams the features were configured for.

FAQ

What is an AI CRM migration?

An AI CRM migration is the move from a legacy CRM (Salesforce Classic, legacy HubSpot, Microsoft Dynamics on-prem, or a small-business platform) to a modern AI-enabled CRM, carrying accounts, contacts, deals, activities, custom fields, and integrations forward in a way that preserves the history the new platform's AI features depend on.

Why do most CRM migrations underperform?

IDC research identifies poor source-system data hygiene as the largest failure factor. Migrations that skip the data preparation phase carry duplicates, inconsistent values, and stale records into the destination, where the AI features then surface insights based on the garbage. The visible problem is on cutover Monday; the actual problem is the four weeks before.

How long does a CRM migration take?

Authority Solutions delivers a focused mid-market migration in roughly twelve weeks: four weeks of data preparation, four weeks of destination build, three weeks of test cutover and rehearsal, and one cutover weekend with managed go-live. Enterprise migrations with extensive integration extend the timeline.

What should we do with our duplicate records?

Run an AI-assisted deduplication pass during phase one, before any export. AI matching surfaces candidate groups by name, email, domain, and address proximity; the operations team reviews and merges in the source system. The destination receives a clean dataset.

Can we keep all our custom fields?

Probably not, and probably should not. Most legacy CRMs accumulate dozens of custom fields that no one uses anymore. The migration is the moment to retire them. Custom fields that survive rationalization get rebuilt with consistent naming and clear purpose in the destination.

What happens to our integrations during migration?

Each integration cuts over on the Sunday of the cutover weekend, with email sync, calendar sync, marketing automation, support system, billing, and product analytics each owned as a sub-project. The general "we will handle integrations" approach is where migrations break; each needs explicit design.

Will we lose deal history?

Not if the migration is planned properly. Activity history (calls, emails, meetings, notes) migrates with the deal record, with timestamps preserved. The team sees the same history in the new platform; the AI features can immediately learn from it.

How do we minimize user disruption?

Plan office hours for the entire cutover Monday and week. Train managers separately before the cutover so they can coach their teams. Run a dry-run cutover into a sandbox in week nine to surface issues that would otherwise hit the live weekend. Communicate the freeze and go-live windows in advance.

What does a CRM migration cost?

Pricing varies by source system, destination platform, integration scope, and data volume. Mid-market migrations typically run twenty-five thousand to one-fifty thousand US dollars for the consulting engagement, plus platform licensing. Enterprise migrations run substantially higher.

Which destination platform is right for us?

The right platform depends on the team's existing stack, the team's existing skills, and the operating model the upgrade is meant to support. HubSpot is the strongest mid-market choice for marketing-led teams; Salesforce leads in enterprise breadth; Microsoft Dynamics fits Microsoft-standardized organizations; Zoho is the strongest value-per-seat tier. The platform selection happens before the migration project starts.

Conclusion

The CRM migration that succeeds is the one that treats data preparation as the project, the destination build as the upgrade, and the cutover weekend as a mechanical execution of plans already validated. The migration that fails is the one that treats the cutover weekend as the project and discovers Monday morning that nothing about the legacy data was ready for the new platform. The difference is four weeks of phase-one labor that the failing migration's RFP did not budget for.

Authority Solutions® migrates mid-market revenue organizations to Salesforce, HubSpot, Microsoft Dynamics, and Zoho across Texas and beyond. We run the data preparation, the destination build, the integration cutover, and the managed go-live with a twelve-week project plan that has shipped clean migrations across industries. The team finishes with the platform the upgrade was for, the data history that makes the AI useful, and a Monday morning that feels like any other Monday.
